SAP Business Suite 7 end of support is now a planning deadline, not a distant roadmap item. SAP says mainstream maintenance for core SAP Business Suite 7 applications runs until the end of 2027, followed by optional extended maintenance until the end of 2030. For CIOs, ERP owners, operations leaders, and CTOs, the decision is bigger than whether to move to SAP S/4HANA. It includes process redesign, data quality, integrations, custom code, reporting, workflow ownership, support cost, and operational risk.
The planning frame is practical: know which SAP products you run, confirm your contract terms with SAP or your SAP partner, map the workflows that depend on the system, then decide which parts should move, change, or retire.
SAP Business Suite 7 end of support dates in plain English
SAP's published maintenance strategy gives companies three dates and support states to understand.

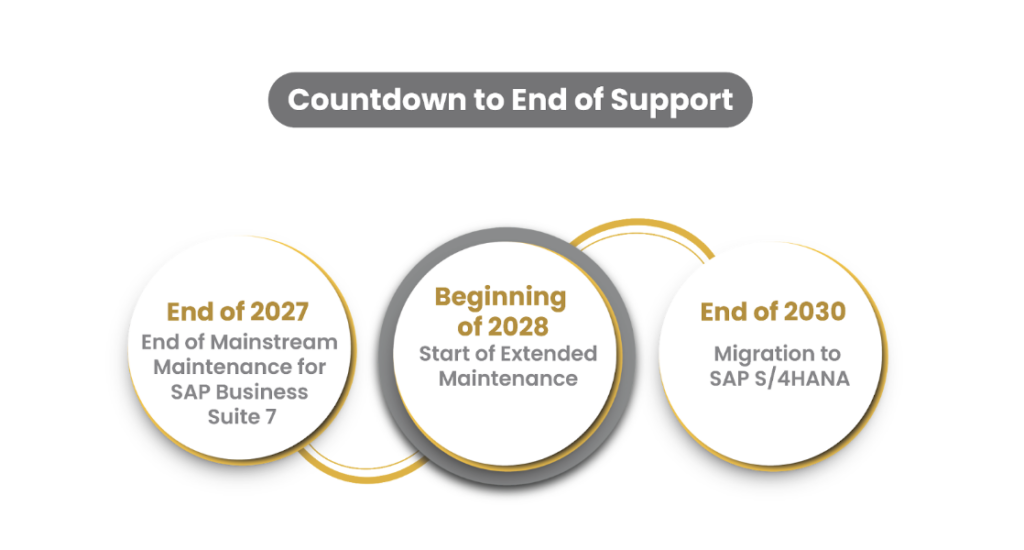

- Mainstream maintenance runs until the end of 2027 for SAP Business Suite 7 core applications.
- Optional extended maintenance runs from 2028 through the end of 2030 for covered Business Suite 7 scope.
- Customer-specific maintenance applies when a customer does not choose extended maintenance, or when extended maintenance has ended.

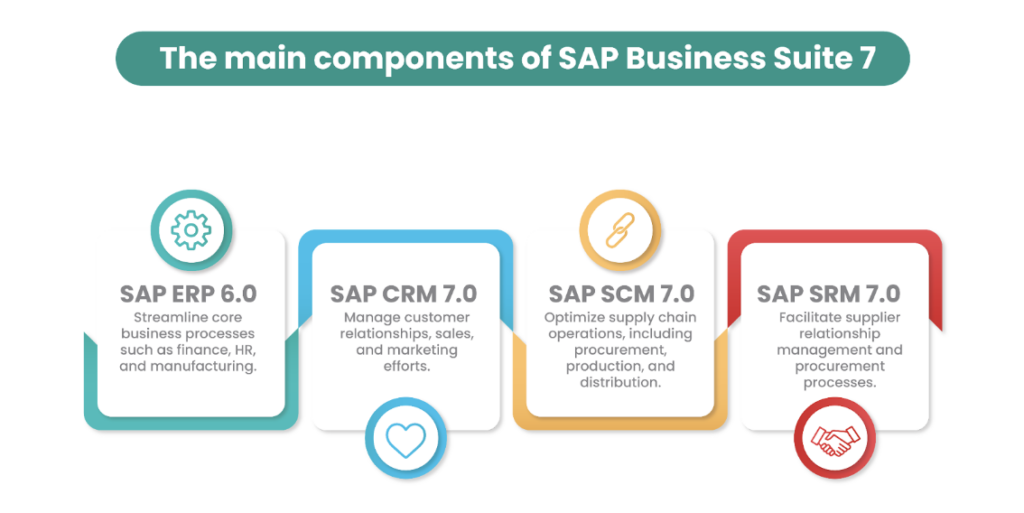

SAP lists the covered core applications as SAP ERP 6.0, SAP CRM 7.0, SAP SCM 7.0, SAP SRM 7.0, and SAP Business Suite powered by SAP HANA. SAP also says extended maintenance for 2028 to 2030 comes with a premium of two percentage points on the maintenance basis for Business Suite 7 scope. Contract terms, system scope, and enhancement package status can vary, so companies should verify their own position directly with SAP or their SAP partner.
SAP also states that SAP S/4HANA has an innovation commitment until the end of 2040, with at least one release in maintenance until then. That makes S/4HANA the long-term SAP destination for many organizations, but a heavily customized SAP ERP estate may need a different transition plan than a standard system.
Sources for lifecycle claims: SAP's maintenance strategy for SAP Business Suite 7 and SAP's S/4HANA and Business Suite 7 maintenance information.
What changes after mainstream maintenance ends
Your SAP systems do not simply stop working after mainstream maintenance ends. The risk is more gradual and more operational. Normal vendor corrections, security updates, legal changes, and regulatory updates become more limited or depend on the support state you choose.
Security is usually the first concern. Older ERP systems often sit at the center of finance, procurement, inventory, production, payroll, or customer operations. Even when the core system is stable, surrounding access points, middleware, file transfers, APIs, reporting tools, and custom portals can expand the attack surface. If standard support narrows, the cost of monitoring and compensating controls rises.
Legal and regulatory updates are another issue. Finance, tax, payroll, reporting, and industry compliance processes change over time. When updates become harder to obtain or test, internal teams may need workarounds, manual checks, or custom patches. Those fixes can work for a while, but they add audit questions and make future migration harder.
Integrations also age. SAP Business Suite 7 environments often connect to warehouse systems, e-commerce platforms, BI tools, banking systems, EDI partners, HR platforms, mobile apps, and internal approval tools. Some of those integrations may use old middleware, brittle batch jobs, custom IDocs, RFCs, direct database access, or undocumented scripts. The closer the 2027 deadline gets, the more important it becomes to know which connections are business-critical and which can be replaced.
Custom code carries a similar burden. ABAP reports, user exits, custom transactions, forms, and workflow modifications may have solved real problems for years. During migration planning, though, each customization needs a decision: keep, replace, redesign, retire, or move into a separate operational layer. Recreating everything one-to-one in S/4HANA can preserve old friction and inflate project scope.
Partner support may also change. Some vendors will support older SAP versions, while others will limit new features, connectors, or guarantees. Internal talent can become harder to retain as consultants and developers focus on S/4HANA and newer analytics stacks.
The main question is not whether SAP Business Suite 7 can run after 2027. The better question is how much risk, cost, and delay your organization is willing to carry while it decides what comes next.
Your realistic options before 2028
Most organizations have more than one path. The right choice depends on business appetite, technical debt, data quality, budget timing, process change tolerance, and how much of the current ERP footprint still fits the company.
| Option | Best fit | Main risk | What to validate first |
|---|---|---|---|
| Move to SAP S/4HANA | Companies committed to SAP as the long-term ERP core | Scope growth from custom code, poor data, and process redesign | Current SAP version, enhancement package, custom ABAP, data quality, integrations, and business process gaps |
| Pay for extended maintenance while migrating | Organizations that need more time but want a controlled SAP transition | Paying for time without reducing migration uncertainty | Contract terms, premium cost, migration roadmap, staffing, and whether 2030 is realistic |
| Selective modernization around existing SAP | Teams with stable ERP core but weak reporting, approvals, analytics, or operational workflows | Creating another layer of complexity without clear ownership | Which workflows should stay in SAP, which should sit outside SAP, and how data will sync |
| Replace specific workflows or custom ERP modules | Companies with outdated custom tools around SAP or departments underserved by the ERP core | Fragmented tools if architecture and governance are weak | Process owners, integration needs, master data rules, support model, and measurable business outcomes |
| Use third-party or customer-specific support as a temporary bridge | Companies that cannot migrate or extend support in time | Longer exposure to compliance, security, and vendor limitations | Coverage boundaries, audit impact, incident response, patch process, and exit plan |
Extended maintenance can help when it buys time for a serious program. It is less useful as a paid delay. If an organization enters 2028 without an inventory, target architecture, data plan, and decision record, the extra years can disappear quickly.
A full move to S/4HANA may be the right answer for the ERP core. Selective modernization may be the right answer for workflows that were bolted onto SAP because no better option existed at the time. In practice, many transition plans combine both.
How to decide between S/4HANA migration and selective modernization
Start with the clean core principle. If a process belongs in ERP because it controls finance, procurement, production, inventory, order management, or compliance, it may need to move into the future SAP core or a standard SAP extension pattern. If a process exists because a department needed better visibility, faster approvals, workload planning, or custom reporting, it may be better served by a separate operational layer connected to SAP.
Data quality is often the first gate. S/4HANA migration planning can expose duplicate vendors, stale materials, inconsistent customer records, missing ownership, unused fields, and reporting workarounds. A brownfield conversion may look faster until data cleanup and custom code remediation are counted. A greenfield implementation may look cleaner until the organization sees how much process change it requires.
Integrations deserve their own review. Some connections should be rebuilt with modern APIs or middleware. Some should be retired. Some should move to cloud services. Others may need temporary bridging during phased migration. This is where Cloud Migration and integration planning become part of ERP strategy rather than a separate IT task.
Custom ABAP should be assessed by business purpose, not only technical compatibility. Ask why each object exists. Is it still used? Does it support a current process? Does S/4HANA provide a standard replacement? Would a custom web application, workflow tool, analytics layer, or department-specific module serve the need with less ERP core complexity?
This is also where Custom Software Development can reduce migration pressure. Some operational processes can be moved into connected software that handles approvals, planning, reporting, notifications, or analytics while SAP remains the system of record for master and transaction data.
Attract Group's Jira-like CRM/ERP on-premises corporate system is a useful reference point. The client's previous internal CRM no longer covered reporting, resource planning, and team management. Attract Group delivered an on-premises CRM/ERP platform with time tracking, project management, analytics, reporting, Slack and email notifications, and Excel export. The project took 9 months, with a budget range of $50,000-$100,000.
That type of work matters in SAP transition planning because many companies carry custom operational tools around ERP. Some are too important to ignore, but too specific to rebuild inside the ERP core. A connected operational layer can handle workload planning, approvals, reporting, and team workflows while the ERP roadmap focuses on finance, procurement, inventory, and other core processes.
The decision should come from a business-case sequence. First, identify the processes that create the most risk or cost if left unchanged. Then separate ERP-core work from ERP-adjacent work. Then compare the cost of migration, extension, replacement, and support for each area. This prevents the program from becoming a single overloaded ERP project.
A practical 18-month planning roadmap
An 18-month plan is tight, but realistic if the organization treats it as a decision program before it becomes a delivery program. Each phase should have an owner, a decision output, and a documented risk position.
- Inventory the SAP estate
Owner: ERP owner with Basis, application, security, and finance input.
Output: Current SAP products, versions, enhancement packages, databases, hosting model, interfaces, add-ons, licenses, contracts, user groups, and business owners.
This phase answers a basic question: what exactly is in scope for SAP Business Suite 7 support exposure?
- Triage business processes
Owner: Business process owners with enterprise architecture.
Output: Process map grouped by keep, redesign, retire, replace, or investigate.
Focus on finance close, procurement, order-to-cash, inventory, production, warehouse, HR, reporting, approvals, and industry-specific workflows. Capture pain points and manual workarounds.
- Audit data and integrations
Owner: Data lead and integration lead.
Output: Data quality report, master data ownership map, integration inventory, failure points, and migration constraints.
This phase should include APIs, middleware, batch jobs, file transfers, EDI, custom reports, BI feeds, mobile apps, and partner systems.
- Define the target architecture
Owner: CIO, CTO, enterprise architect, and ERP steering group.
Output: Architecture choices for SAP core, cloud services, custom operational modules, reporting, identity, integration, and support.
This is where the organization decides what belongs in S/4HANA, what belongs in surrounding platforms, and what should be sunset.
- Build the migration and modernization plan
Owner: Program manager with ERP, business, data, and software delivery leads.
Output: Roadmap, cost model, dependency plan, resource plan, testing approach, and support plan.
The plan should compare greenfield, brownfield, hybrid, and selective modernization options. It should also state whether extended maintenance is needed as a bridge.
- Run a pilot
Owner: Delivery lead and selected business unit owner.
Output: Tested migration slice, integration proof, data migration sample, support process, and change plan.
A pilot reduces uncertainty before the organization commits to the full program. Choose a process that is meaningful but contained enough to learn from quickly.
- Prepare cutover and support
Owner: ERP operations, support lead, security, and business owners.
Output: Cutover checklist, rollback plan, test sign-off, training plan, hypercare model, incident routing, and post-go-live backlog.
Support planning should include internal teams, SAP partners, software vendors, and custom development teams responsible for ERP-adjacent systems.
Questions to ask before choosing a partner
The right partner should help you reduce uncertainty before selling a migration route. Use these questions to test whether they understand ERP transition risk across SAP, data, integrations, and custom workflows.
- Which SAP Business Suite 7 products, versions, and enhancement packages do we run today?
- Which parts of our scope are covered by mainstream maintenance, extended maintenance, or customer-specific maintenance?
- What custom ABAP, reports, forms, user exits, and workflows are still used?
- Which custom objects can be retired, replaced by standard S/4HANA functionality, or moved outside the ERP core?
- What is our full integration inventory, including batch jobs, EDI, APIs, file transfers, middleware, BI feeds, and direct database connections?
- What data quality issues could block or slow migration?
- Which migration path fits our system: greenfield, brownfield, hybrid, or phased selective modernization?
- What downtime limits do our business units have?
- How will testing cover finance, procurement, inventory, production, reporting, security, and external integrations?
- What support model will cover the transition, hypercare, and future custom modules?
- Would custom operational layers reduce the ERP core scope, or would they add unnecessary complexity?
- How will the partner document decisions so future teams understand why each process moved, stayed, changed, or retired?
A strong partner should also be clear about boundaries. SAP contract details and lifecycle terms should be verified with SAP or your SAP partner. Custom software teams can help with ERP-adjacent workflows, integrations, data flows, portals, reporting, and operational modules, but they should not guess at your SAP maintenance rights.
Need to plan an ERP transition path?
If SAP support dates are forcing a decision, Attract Group can help map ERP-adjacent workflows, integration risks, and custom operational modules before a full migration budget is committed. The goal is to give leadership a clear view of what belongs in the ERP core, what can be modernized around it, and what should be retired.
For companies weighing S/4HANA migration, extended maintenance, selective modernization, or custom workflow replacement, ERP Software Development Services can support discovery, architecture planning, module design, integration work, and long-term Maintenance & Support. The best next step is a focused assessment of your current SAP-dependent processes, so the 2027 and 2030 dates become planning anchors instead of last-minute pressure.
